Air Traffic Flow and Capacity Management (ATFCM) balances forecast traffic demand against the available capacity of aerodromes and airspace sectors.
ATFCM measures are used to:
CTOT compliance
Controllers shall comply with all applicable CTOTs, regardless of whether A-CDM procedures are in use at the departure aerodrome.
When handling a regulated flight, ATC shall:
Aerodrome capacity is the number of arrivals and departures that an airport can safely and efficiently handle during a specified period. It represents the declared operational capacity, not the airport’s absolute physical limit.
Capacity is not fixed and may change throughout the day according to:

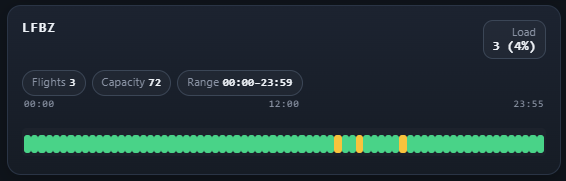

The capacity display compares the expected traffic demand with the declared capacity for the selected aerodrome and time range.
In the example shown:
The display allows controllers and flow managers to identify potential periods of congestion before they become operationally significant.
When forecast demand exceeds the available capacity, an Air Traffic Flow and Capacity Management (ATFCM) measure may be introduced. Depending on the situation, this may include departure restrictions, regulated arrival rates, CTOT allocation, ground delay, or tactical rerouting.
The objective is to balance demand with the airport’s available capacity and prevent excessive airborne holding, ground congestion, and controller workload.

En-route sector capacity is the amount of traffic that a sector can safely and efficiently manage during a specified period. It is based not only on the number of aircraft, but also on the expected controller workload and traffic complexity.
Sector capacity may be defined using:

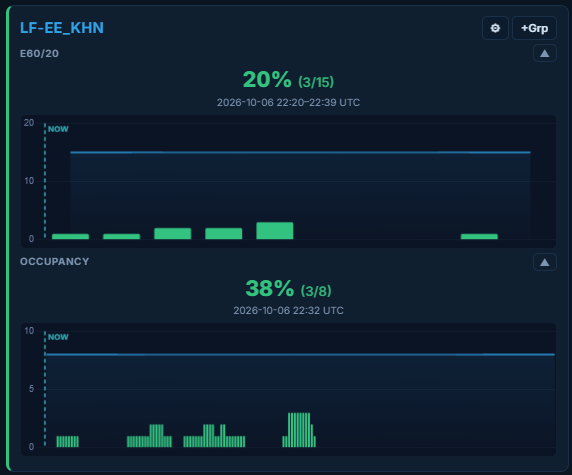

The sector capacity display compares forecast traffic with the declared capacity of the selected sector.

In the example shown:
The entry-rate graph helps identify periods with a high number of incoming aircraft. The occupancy graph shows how many aircraft are expected to be inside the sector at the same time.
A sector may remain below its occupancy limit while still receiving too many aircraft within a short period. For this reason, both values must be monitored together.
The available capacity may change according to:
A high percentage does not automatically mean that the sector is overloaded, but it indicates that less capacity remains available for additional or unexpected traffic.
When forecast demand exceeds the declared capacity, flow-management action may be required. This may include splitting sectors, balancing traffic between routes, applying level restrictions, rerouting aircraft, or introducing an ATFCM regulation.
The available sector capacity may vary according to weather, staffing, military activity, traffic complexity and the active sector configuration.
An ATFCM regulation may be introduced when forecast demand is expected to exceed the available capacity of an aerodrome or airspace sector.
A regulation limits the number of flights entering the affected resource during a specified period. Departure times may therefore be adjusted to distribute demand and minimise overall network delay.

A flight affected by a regulation may be assigned a Calculated Take-Off Time (CTOT). The CTOT represents the departure slot allocated to the flight.
Holding the aircraft on the ground until its allocated departure window reduces airborne holding and prevents additional congestion at the regulated location.
The applicable CTOT tolerance window is:
CTOT −5 minutes to CTOT +10 minutes
For example, an aircraft with a CTOT of 1930 UTC shall take off between 1925 UTC and 1940 UTC.
Operational requirement
ATC shall not permit a regulated flight to take off outside its CTOT tolerance window. If the flight cannot comply, a revised CTOT shall be obtained before departure.
A CTOT is a network constraint, whereas a TTOT is the take-off time produced by the local airport departure sequence. The two times serve different purposes and shall not be treated as interchangeable.
At an A-CDM aerodrome, the CDM system integrates the CTOT into the local departure sequence. It considers the expected taxi-out time (EXOT), runway capacity, start-up delay and any additional operational time to calculate a TSAT intended to bring the aircraft to the runway within the CTOT tolerance window.
At a non-A-CDM aerodrome, no TSAT is calculated. The controller instead plans start-up and pushback from the CTOT, its tolerance window and the expected taxi time.
In both cases, the currently assigned CTOT remains applicable until the ATFCM system revises or cancels it.
A Ready (REA) message informs the ATFCM system that a regulated aircraft is fully ready to depart. It may allow an earlier CTOT to be allocated if capacity becomes available, but it does not cancel the current CTOT and does not authorise departure outside the current tolerance window.
If a flight can no longer depart within its CTOT tolerance window, its planning information shall be updated and a revised CTOT obtained before take-off. The operational method for submitting a ready message or requesting a new CTOT depends on whether the departure aerodrome uses A-CDM procedures.
In addition to CTOT-based regulations, short-term ATFCM measures may be used to manage unexpected demand, reduce controller workload or limit traffic complexity.
Within the VATSIM European network, cross-border measures are coordinated through the European Collaborative Flow Management Programme (ECFMP).
Common measures include:
Minimum Departure Interval
When an MDI is implemented through the ATFCM system, affected departures may receive CTOTs that provide the required spacing at source. This prevents excess traffic from reaching the runway holding point or affected airspace at the same time.
For network-standard CTOT procedures and message definitions, refer to the EUROCONTROL ATFCM Users Manual.
